Concrete Calculator: Yards, Bags & Volume

Use this concrete calculator to estimate cubic yards, cubic feet, cubic meters and bag quantities for slabs, walls, footings, circular slabs, piers, post holes and concrete steps. Enter the project dimensions and choose a waste allowance to see both the calculated volume and the amount to order.

Concrete Calculator

Calculate concrete volume, cubic yards, cubic feet, cubic meters, bag counts, weight and optional material cost for slabs, walls, footings, circular slabs, round piers, post holes and solid concrete steps.

Project dimensions

ft
ft
in
ft
ft
in
ft
ft
ft
ft
in
pcs
in
ft
pcs
Use this for solid cylindrical concrete piers, Sonotube pours and round concrete columns.
pcs
in
ft
ft
in
in
pcs
This estimates solid cast-in-place steps built up from grade. It is not for suspended reinforced-concrete stairs with a separate waist slab.
Optional cost settings
price
each

Your concrete estimate

Recommended order quantity — Includes the selected waste allowance.
Calculated volume before waste —
Order volume after waste —
Cubic yards —
Cubic feet —
Cubic meters —
Estimated weight —
Ready-mix cost —
Bagged cost —
Approximate bag counts
40 lb bags —
50 lb bags —
60 lb bags —
80 lb bags —
Bagged concrete is usually practical for small quantities.
Calculation assumptions: normal-weight concrete is estimated at 150 lb/ft³. Bag counts use typical dry-mix yields of about 0.30 ft³ for 40 lb, 0.375 ft³ for 50 lb, 0.45 ft³ for 60 lb, and 0.60 ft³ for 80 lb bags. Product yields vary, so check the bag label before buying.

Do not use normal concrete weight values for lightweight materials such as foam concrete, because their density can be much lower than standard concrete

Concrete calculator used to estimate concrete volume for a slab pour
A concrete calculator helps estimate slab volume, waste allowance and material quantity before ordering concrete.

How Much Concrete Do I Need?

Start with the actual volume of the concrete you plan to place.

For a rectangular slab, multiply the length by the width by the concrete thickness. Convert the result to cubic yards if you are ordering ready-mix concrete.

One cubic yard contains 27 cubic feet.

The calculator above separates the calculated concrete volume from the recommended order quantity. The second value includes your selected waste allowance, so you can see exactly how much extra material has been added.

For example, a 10 ft × 10 ft slab at 4 inches thick contains about 1.23 cubic yards of concrete before waste. With a 10% allowance, the calculator increases the order quantity to about 1.36 cubic yards.

For irregular areas, divide the pour into simple rectangles or circles, calculate each part separately, then add the volumes together.

Concrete Volume Formulas

The formula changes with the shape of the pour, but the calculation always starts with volume.

ProjectConcrete volume formula
Rectangular slabLength × Width × Thickness
WallLength × Height × Thickness
Strip footing or trenchLength × Width × Depth
Circular slabπ × Radius² × Thickness
Round pier or columnπ × Radius² × Height
Post holesπ × Radius² × Depth × Quantity
Solid concrete stepsWidth × Rise × Run × [n(n+1) ÷ 2]

For imperial measurements:

Cubic feet = Length (ft) × Width (ft) × Thickness (in) ÷ 12

Then:

Cubic yards = Cubic feet ÷ 27

For metric measurements, keep the main dimensions in meters and convert millimeter thickness to meters before multiplying.

The solid-step calculation assumes conventional solid cast-in-place steps built up from grade. It is not intended for suspended reinforced-concrete stairs with a waist slab.

Engineer Note

This calculator estimates material quantity, not structural capacity.

Concrete thickness, reinforcement, subgrade support, joints and concrete strength still need to suit the actual loading and site conditions. ACI treats slab thickness and soil support as design considerations for slabs-on-ground rather than values that should be selected from a calculator alone.

Common Concrete Slab Sizes

The table below shows the exact geometric concrete volume before waste.

Use it for quick planning, then add a waste allowance before placing an actual order.

Slab size4 in thick5 in thick6 in thick
10 × 10 ft1.23 yd³1.54 yd³1.85 yd³
12 × 12 ft1.78 yd³2.22 yd³2.67 yd³
20 × 20 ft4.94 yd³6.17 yd³7.41 yd³
24 × 24 ft7.11 yd³8.89 yd³10.67 yd³
30 × 40 ft14.81 yd³18.52 yd³22.22 yd³

A 20 × 20 ft slab, for example, takes about 4.94 cubic yards at 4 inches thick before waste. Increasing the thickness to 6 inches raises that volume to about 7.41 cubic yards.

That difference is why I would measure the required thickness before pricing concrete. A small change in thickness over a large area changes the order quickly.

If you are trying to estimate the complete installed slab price, including labor, reinforcement, base preparation and finishing, use the Concrete Slab Price Calculator instead.

How Much Does 1 Yard of Concrete Cover?

One cubic yard of concrete always contains 27 cubic feet, but the surface area it covers changes with thickness.

Concrete thicknessApprox. area covered by 1 yd³
3 in108 sq ft
4 in81 sq ft
5 in64.8 sq ft
6 in54 sq ft
8 in40.5 sq ft

So one cubic yard will cover about 81 square feet at 4 inches thick.

At 6 inches thick, the same cubic yard covers only about 54 square feet.

These numbers are theoretical coverage before waste, uneven subgrade or variations in the forms.

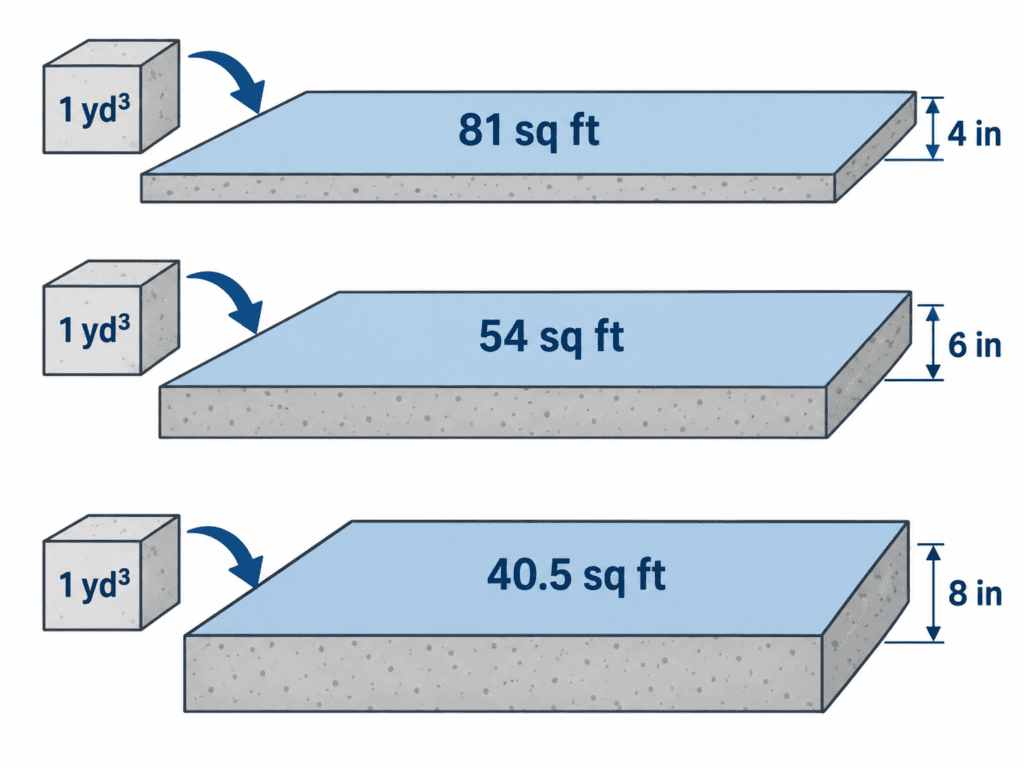

Concrete calculator diagram showing one cubic yard covering 81 sq ft at 4 inches thick, 54 sq ft at 6 inches, and 40.5 sq ft at 8 inches.
One cubic yard covers less area as slab thickness increases.

How Many Bags of Concrete Do I Need?

Bagged concrete is usually sold by weight, but each bag produces a certain volume of mixed concrete.

That yield is what matters when estimating how many bags to buy.

The calculator uses the following typical yields:

Bag sizeApprox. yieldApprox. bags per cubic yard
40 lb0.30 ft³90
50 lb0.375 ft³72
60 lb0.45 ft³60
80 lb0.60 ft³45
90 lb0.675 ft³40

These values match the published yields for QUIKRETE Concrete Mix No. 1101. The manufacturer lists approximately 0.30 ft³ for a 40-lb bag, 0.375 ft³ for 50 lb, 0.45 ft³ for 60 lb, 0.60 ft³ for 80 lb and 0.675 ft³ for 90 lb.

Actual yield can vary between products, especially with specialty or fast-setting mixes. Check the yield printed on the bag before purchasing.

Example: 80-lb Bags for a 10 × 10 Slab

A 10 × 10 ft slab at 4 inches thick contains about 33.3 cubic feet.

At 0.60 cubic feet per 80-lb bag:

33.3 ÷ 0.60 ≈ 56 bags

That is before adding extra material.

With a 10% waste allowance, the calculator gives about 62 bags.

Common Concrete Thicknesses

Thickness has a large effect on concrete quantity, so do not choose it only to make the material estimate cheaper.

These values are useful planning starting points, not structural design requirements.

ProjectCommon planning thicknessPractical note
Walkway4 inCommon for normal foot traffic
Patio4 inBase preparation and drainage still matter
Small shed slab4–5 inLoad and soil conditions can change the requirement
Residential driveway5–6 inVehicle loading and base support matter
Garage or heavier slab6 in or moreReinforcement and joint layout may also need design

For structural slabs, heavy equipment, poor soil, unusual loads or foundations, use project-specific design information rather than this table.

ACI’s floor and slab guidance specifically identifies slab thickness, base/subbase preparation, concrete strength, reinforcement and joints as items that should be addressed in the design documents.

If you are estimating a driveway rather than just concrete quantity, the Concrete Driveway Cost Calculator gives a more complete project estimate.

Bagged Concrete or Ready-Mix?

Bagged concrete makes sense for small pours.

I would normally consider it for post holes, isolated repairs, small pads and short sections where setting up a ready-mix delivery would be unnecessary.

The calculation changes once the bag count becomes large.

One cubic yard requires roughly 45 80-lb bags or 60 60-lb bags before waste. Mixing several cubic yards by hand means handling thousands of pounds of dry material while also trying to place and finish the concrete before it starts setting.

For a slab, driveway or larger footing, ready-mix is usually the more practical option.

Ready-mix also lets the crew place a larger volume continuously, which is important when the pour should be completed without unnecessary interruptions.

If you plan to order from a ready-mix producer, NRMCA’s Concrete in Practice series includes CIP 31 specifically for ordering ready-mixed concrete.

For a small DIY slab, also read our Dry Pour Concrete guide before deciding to place dry bagged mix and add water afterward. Dry placement is not a general substitute for properly mixing concrete.

How Much Extra Concrete Should You Order?

The calculated dimensions give you the theoretical volume.

Real jobs rarely match that number perfectly.

The bottom of an excavation may be uneven. Forms can move slightly. Post holes can widen during digging. Some concrete also remains in the mixer, wheelbarrow, chute or pump line.

That is why I prefer to show the waste allowance separately from the actual geometric volume.

Site conditionPlanning allowance
Accurate forms and flat base5%
Normal slab, footing or post-hole work10%
Rough subgrade or uneven excavation15%

For many ordinary residential pours, 10% is a reasonable starting allowance.

Sakrete likewise recommends adding about 10% when estimating bagged concrete so the job does not run short because of uneven ground, form variation or normal losses.

Do not treat 10% as an automatic rule for every project. A large commercial pour with carefully surveyed forms is different from a hand-dug footing or a row of oversized post holes.

How Much Does Concrete Weigh?

For planning purposes, the calculator uses 150 lb per cubic foot, or roughly 2,400 kg/m³, for normal-weight concrete.

That means one cubic yard is approximately:

27 × 150 = 4,050 lb

or just over 2 US tons.

The American Concrete Institute defines normal weight concrete at approximately 150 lb/ft³ (2,400 kg/m³).

Do not apply the same number to lightweight materials. If you are working with glass-fiber reinforced concrete panels, use the GFRC Weight Calculator instead.

Before You Order Concrete

Run the quantity calculation again after the forms or excavation are actually in place.

I would check the final dimensions from the inside faces of the forms rather than relying only on the original plan dimensions.

Also check the base before ordering. A low area in the subgrade becomes extra concrete if it is not corrected first.

Have reinforcement, embedded items and formwork ready before the truck arrives. Concrete quantity is only one part of the pour. Placement access and finishing time can become the bigger problem once fresh concrete is on site.

For large or structural pours, confirm the final quantity and specifications with the ready-mix supplier or project engineer before placing the order.

Concrete Calculator FAQs

How much concrete do I need for a 10 × 10 slab?

A 10 × 10 ft slab at 4 inches thick needs about 1.23 cubic yards of concrete before waste.
With a 10% allowance, the order quantity becomes about 1.36 cubic yards.
At 6 inches thick, the same 10 × 10 slab requires about 1.85 cubic yards before waste.

How much does one cubic yard of concrete cover?

One cubic yard covers about 81 square feet at 4 inches thick.
At 5 inches thick, it covers about 64.8 square feet. At 6 inches thick, it covers about 54 square feet.
These are theoretical values before waste.

How many 80-lb bags of concrete make one cubic yard?

An 80-lb bag that yields about 0.60 cubic feet requires approximately 45 bags to produce one cubic yard.
Add your waste allowance after calculating the project volume.

How many 60-lb bags of concrete make one cubic yard?

A typical 60-lb concrete mix bag yields about 0.45 cubic feet.
One cubic yard therefore requires approximately 60 bags before waste.

Should I use concrete bags or ready-mix?

Use bags for small projects where the total quantity is manageable.
For larger slabs, driveways and footings, ready-mix is usually easier because a large volume can be placed continuously without hand-mixing dozens or hundreds of bags.

How much extra concrete should I order?

A 10% allowance is a practical starting point for many residential projects.
Use less when the forms and excavation are very accurate. Consider more when the excavation is irregular or the actual pour dimensions are difficult to control.
